Summary: Patna Metro's first interchange station at Khemnichak is progressing rapidly. With a scheduled completion window targeting August 2026, it features a state-of-the-art two-storey elevated structure, 5 passenger lifts, 6 escalators, and a special U-turn crossover system for trains.
The landscape of urban public transport in Patna is undergoing a massive transformation with the development of the Phase-1 Patna Metro network. Among the 24 planned stations, the Khemnichak Interchange Station stands out as the most critical node of the entire project. Designed to connect Corridor-1 (Red Line) and Corridor-2 (Blue Line), this station will serve as the gateway for lakhs of passengers, allowing them to switch routes seamlessly without exiting the metro system or purchasing separate tickets.
Why Khemnichak is the Heart of Patna Metro
An interchange station is the backbone of any successful metro network. In Patna, Corridor-1 runs from Danapur Cantonment in the west to Khemnichak in the east (covering 16.86 km with 14 stations). Corridor-2 runs from Patna Junction in the center to New ISBT in the east (covering 14.05 km with 12 stations). Khemnichak is the intersection point where these two vital corridors cross paths.
Without the Khemnichak interchange, passengers from western suburbs like Danapur, Saguna More, and Patliputra would have no direct way to access the eastern parts of the city (like Kankarbagh, Zero Mile, and the New ISBT terminal) via the metro. This station bridges the geographical gap, making the entire network cohesive and highly valuable for commuters.

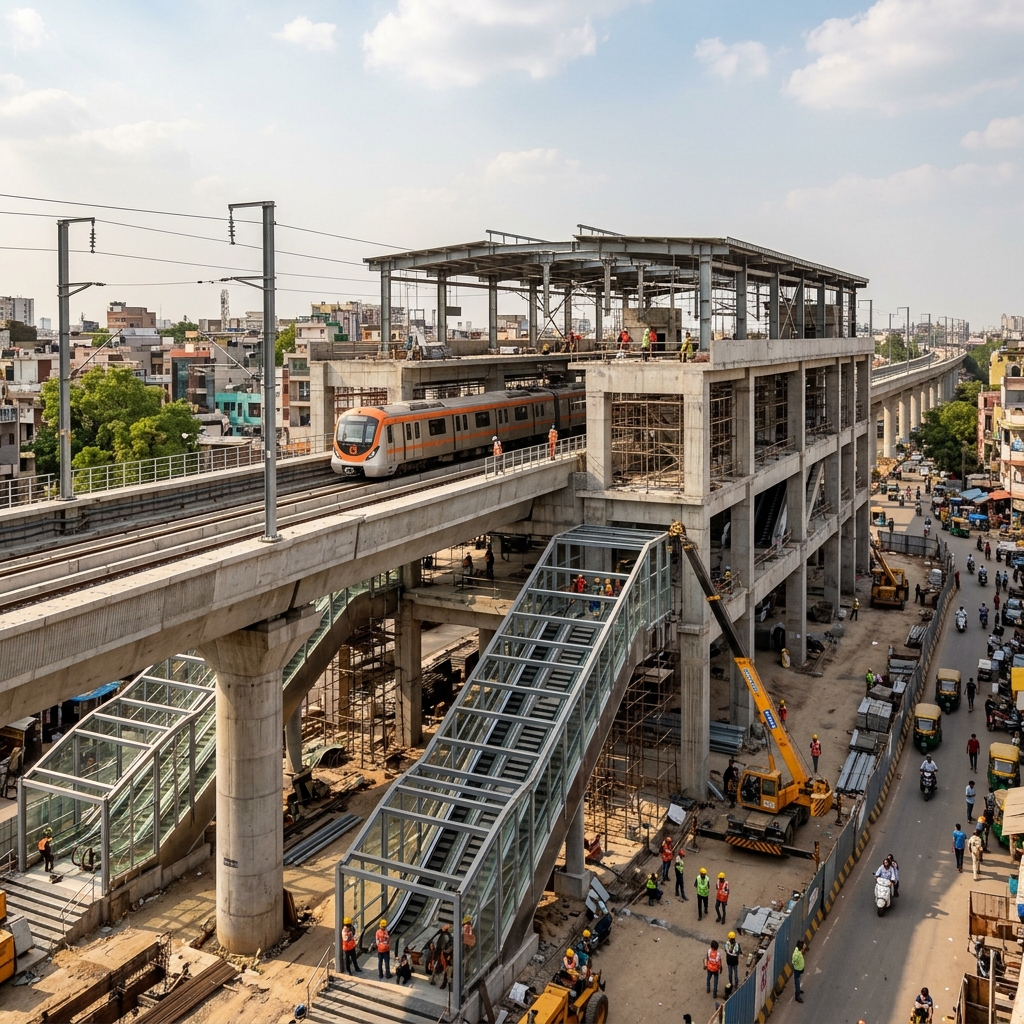

Unique Architectural Design: A Two-Storey Elevated Wonder
Unlike standard metro stations which feature a single platform level, Khemnichak is being built as a spacious two-storey elevated structure. The engineering design is optimized to handle high peak-hour traffic and facilitate quick transfers. The breakdown of the levels is as follows:
- Ground Level: Houses the road level, supporting normal city traffic on the busy Patna Bypass Road.
- Concourse Level (First Floor): Houses the ticketing counters, automatic fare collection (AFC) gates, security checkpoints, administrative offices, and passenger amenities.
- Platform Level (Second Floor): Houses the tracks and platforms for both Corridor-1 and Corridor-2. The layout ensures that passengers can transfer between lines simply by changing platforms on the same level or using the connecting walkways, minimizing transit fatigue.
⚡ Key Architectural Features & Facilities
- 5 Lifts: High-speed elevators designed for elderly, disabled, and luggage-carrying passengers.
- 6 Escalators: Modern heavy-duty escalators to facilitate vertical passenger movement.
- 2 Entry & Exit Gates: Located strategically on both sides of the bypass road to prevent traffic jams.
- CCTV Surveillance: Over 100 cameras installed across platforms, concourses, and parking lots for safety.
- Bilingual Signage: Clear navigation guides in Hindi and English for hassle-free transit.
Technical Details: The Special Crossover (U-Turn) System
To enable efficient train operations and maintain regular headway, DMRC (Delhi Metro Rail Corporation) is implementing a crossover system (U-turn) at Khemnichak station. This technical system allows trains to switch tracks at the terminal station, facilitating a smooth U-turn.
- For Corridor-2 (Blue Line): Trains arriving from the Patna Junction side can cross over the tracks, change directions, and return toward the New ISBT terminal.
- For Corridor-1 (Red Line): Trains arriving from Danapur Cantonment can switch tracks, allow passengers to disembark, and turn back to travel westwards.
This crossover system is critical for maintaining a 5-to-7-minute frequency (headway) during peak office and school hours, ensuring commuters are never kept waiting.
CMRS Safety Reviews and Progress Update
The safety of passengers is paramount before any commercial operations can begin. Recently, the Commissioner of Metro Rail Safety (CMRS) conducted a detailed inspection of the priority corridor (which includes Khemnichak). The safety commissioner flagged 22 technical compliance points relating to electrical supply, signaling calibration, and platform screen margins.
PMRCL (Patna Metro Rail Corporation Limited) engineers have submitted detailed answers and rectification reports for all 22 points. The final approval and clearance report from the CMRS is expected within the next few weeks. This clearance will officially allow the priority corridor to open for public passenger trials, bringing the city one step closer to its metro dream.
Government Commitment and Fast-Track Status
The Bihar state government has placed Patna Metro on its list of highest-priority infrastructure works. In a recent high-level review meeting, Deputy Chief Minister Samrat Choudhary directed the urban development department and DMRC representatives to ensure that no bureaucratic delays halt construction progress. The government has committed extra funds and facilitated administrative clearances to ensure that the August 2026 operational target for the Khemnichak interchange is met without failure.
| Parameters | Corridor-1 (Red Line) | Corridor-2 (Blue Line) |
|---|---|---|
| Termini | Danapur Cantonment – Khemnichak | Patna Junction – New ISBT |
| Total Distance | 16.86 Kilometers | 14.05 Kilometers |
| Number of Stations | 14 Stations | 12 Stations |
| Khemnichak Platform Status | 70% Civil Work Completed | 100% Civil Work Completed |
| Target Completion | August 2026 | July 2026 |
How It Impacts Local Commuters
For the average Patna resident, the opening of the Khemnichak station represents a massive lifestyle improvement. Currently, traveling from Danapur in the west to Kankarbagh or the bypass area in the east requires navigating congested roads like Bailey Road and Ashok Rajpath. During peak hours, this trip can take up to 90 minutes. Once the metro is operational, this commute will be cut down to just 35 minutes in a clean, air-conditioned environment. By providing a dependable alternative to private vehicles and shared auto-rickshaws, the metro will reduce carbon emissions and clear up Patna's roads.
